Introduction
A product that performs flawlessly as a prototype can still fall apart the moment you try to build a hundred of them. That gap between "it works" and "we can make this reliably" is exactly what a pilot production run is designed to close.
A pilot run is a limited manufacturing build used to test whether a product, and the process behind it, is ready for larger-scale output. The AIAG's Advanced Product Quality Planning framework places pilot production squarely inside product-and-process validation, before a company ever commits to full production launch.
This guide is for product developers, engineers, founders, procurement teams, and manufacturing managers working on automotive, defense, consumer electronics, dental, orthopedic, or other physical products. We'll cover what a pilot run actually is, why it matters, how the process works step by step, where it applies, and how to decide whether you're ready to scale.
Key Takeaways
- A pilot run replicates intended production conditions as closely as practical, rather than serving as a larger prototype batch
- Success depends on validating manufacturability, repeatability, quality, and workflow together
- Clear objectives and pass/fail criteria, set before the build, make results measurable and decision-ready
- Findings should drive documented corrective action or a justified go/no-go decision
What Is a Pilot Run in Manufacturing?
A pilot run is a small-scale production build conducted before full-scale manufacturing. It uses production-intent materials, tooling, equipment, work instructions, inspection methods, and labor wherever feasible. The goal is to prove the product can be made consistently, economically, and to spec using the actual process you intend to scale—not to produce a few more samples.
A pilot run is a manufacturing validation activity. It is not automatically a market launch, a customer beta test, or final regulatory approval for every regulated product category. Those are separate decisions with their own requirements.
Pilot Run vs. Prototype
These two activities answer different questions:
- Prototype build: Tests whether the design works — fit, form, and function
- Pilot run: Tests whether the manufacturing system can reproduce that design reliably, at rate, using real production inputs
A prototype might be machined by hand or 3D printed using a different material than your final part. A pilot run uses the tooling, fixtures, and process you'll actually run in production.

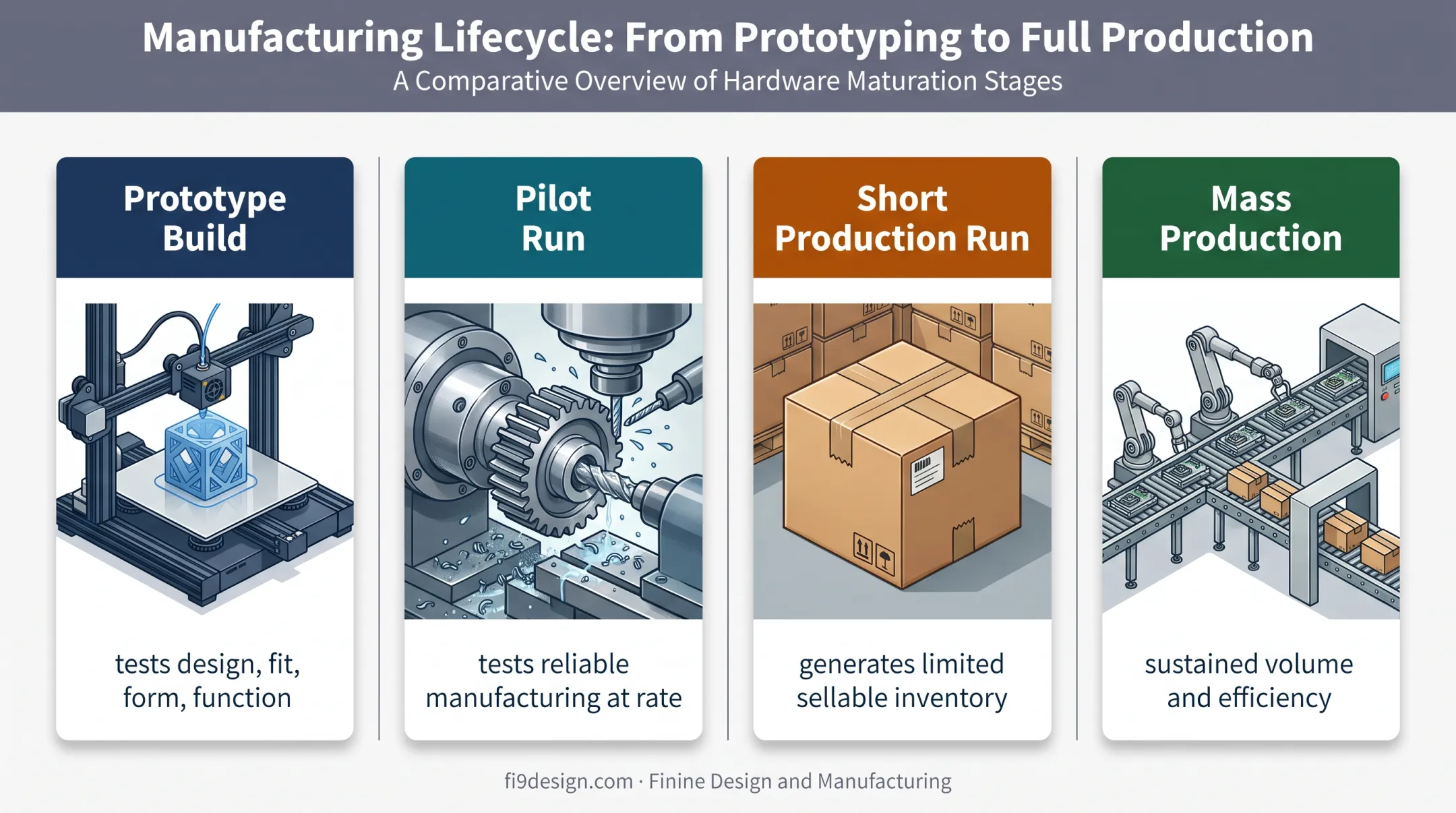

Pilot Run vs. Short Production Run vs. Mass Production
A short production run may generate limited sellable inventory — it's about output, not validation. Mass production focuses on sustained volume and efficiency once the process is already proven. A pilot run sits between them: it's a controlled test, not a commercial commitment.

Other terms you'll encounter: trial production run, pre-production run, production validation run, and production validation testing. Terminology shifts by company and industry — garment manufacturers tend to say "trial production run," while automotive teams often say "pilot production" following AIAG conventions.
Why Pilot Production Runs Are Used
Skipping a pilot run does not remove risk. It only pushes discovery later, when fixes cost more and schedules are harder to recover.
Catching Problems Before They Scale
A pilot run exposes:
- Design-for-manufacturing issues that weren't visible in a one-off prototype
- Tooling limitations under repeated cycles
- Material variation between lots or suppliers
- Assembly difficulties that only show up with multiple operators
- Inspection gaps where defects slip through
It also tests whether tolerances, interfaces, finishes, and critical features can be hit consistently — not just once under ideal conditions.
What to Measure
Teams typically track:
- Yield and first-pass acceptance
- Defect categories, rework, and scrap
- Cycle time and downtime
- Inspection results against critical features
These numbers show where the process will break before you commit to a much larger order.
The Cost of Skipping or Rushing It
The GAO's review of Department of Defense manufacturing risk management found that programs lacking manufacturing knowledge at key decision points saw cost growth and schedule delays. Late discoveries included inconsistent supplier quality and rework found deep into production.
Rushing past validation tends to surface the same issues downstream:
- Expensive tooling rework
- Repeated production runs
- Delayed launches
- Inconsistent quality reaching customers
- Supplier disputes over out-of-spec components
Pilot runs matter even more when safety, reliability, or compliance is on the line, including medical, defense, automotive, and electronics products. A successful pilot supports your quality system with production evidence. It does not replace applicable regulatory requirements.
How the Pilot Run Process Works

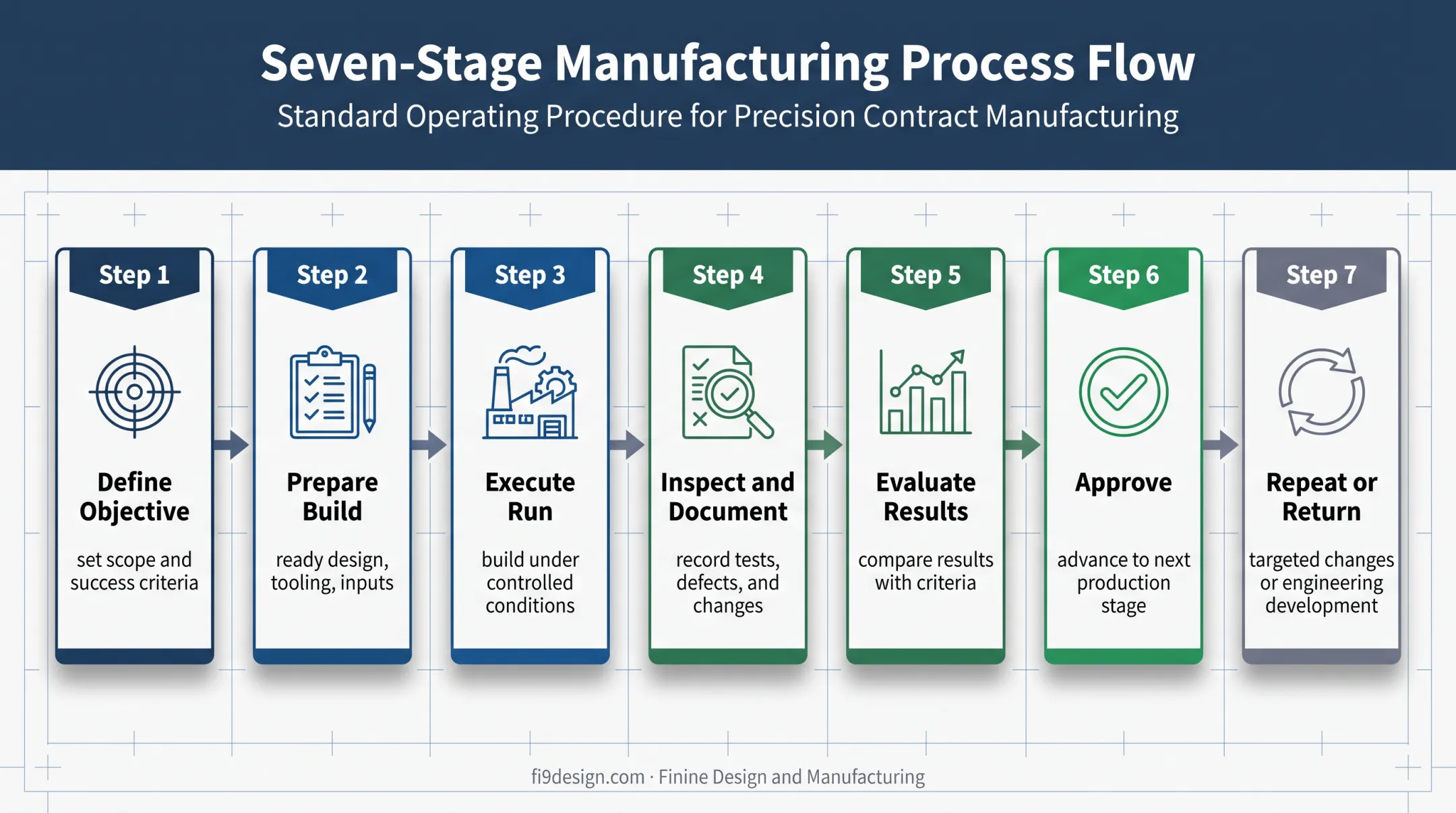

Think of a pilot run as a planned feedback loop: define the objective, prepare the inputs, build a controlled quantity, inspect and test the output, analyze findings, correct issues, and make a documented decision.
Whenever feasible, run it with production-intent inputs—not stand-ins. That means real materials, tooling, fixtures, operators, assembly sequence, inspection tools, packaging, and supplier components.
Step 1: Define the Objective, Scope, and Success Criteria
Before anything gets built, nail down the specific questions this run needs to answer:
- Does the tooling produce acceptable parts consistently?
- Is the assembly sequence repeatable across operators?
- Does a supplier component perform as intended under real conditions?
- Can the process hit the required throughput?
Acceptance criteria covering product quality, critical dimensions, functional performance, defect limits, process capability, and documentation need to be agreed upon before the build starts. Deciding what "pass" looks like after you've already run the parts invites bias.
Step 2: Prepare the Pilot Build
This step is where most of the groundwork happens:
- Confirm design and document readiness — released drawings or CAD files, bill of materials, approved materials, revision control, work instructions, and inspection plans
- Verify physical readiness — tooling, fixtures, machines, gauges, trained operators, and supplier parts
- Lock in logistics — material quantities, safety procedures, and production scheduling
A cross-functional review involving design engineering, manufacturing engineering, quality, procurement, operations, and project leadership catches gaps no single department would spot alone.
Step 3: Execute, Inspect, and Document the Run
Record what actually happens, not a cleaned-up version of it. If something goes wrong and gets fixed informally without documentation, you lose the evidence needed to analyze it later.
This step includes:
- In-process and final inspections
- Functional testing and dimensional checks
- Material verification and cosmetic review
- Packaging checks and any application-specific testing
Operators and engineers should also log:
- Downtime, rework, scrap, and substitutions
- Tooling adjustments and defects
- Near misses and unexpected component interactions
These details often matter more than the pass/fail number itself.
Step 4: Evaluate Results and Decide What Happens Next
Compare observed results against the acceptance criteria set in Step 1. Separate isolated anomalies from repeatable process weaknesses — a single scratched part is a different problem than a dimension that drifts across the whole batch.
Significant findings warrant root-cause analysis, with corrective actions that assign an owner, a due date, a verification method, and the documents or tooling affected. From there, three outcomes are typical:
- Approve the process for the next production stage
- Repeat the pilot after targeted changes
- Return the product to design or engineering development

This is where an integrated manufacturing partner pays off. Finine Design and Manufacturing handles CAD modeling, prototyping, CNC machining, urethane casting, injection molding, and finishing in one workflow.
When a pilot exposes a tooling issue or calls for a material change, those fixes can move without handing the project to a new vendor. Not every build uses every capability, but one accountable team shortens the loop from "we found a problem" to "we fixed it."
Where Pilot Runs Apply and What Affects Results
Pilot runs show up any time risk is high enough to justify the extra step:
- New product introduction or major design changes
- New tooling or materials
- Supplier qualification and second-source validation
- Process transfers or equipment changes
- Significant volume increases
They don't have to wait for final pre-production. Teams often run an earlier pilot to validate a critical component, test manufacturability, or vet a supplier before locking expensive tooling or irreversible design decisions.
Variables That Affect Pilot Results
Inputs:
- Material grade and lot-to-lot variation
- Supplier consistency
- Tooling condition, finishes, adhesives, packaging
Operating conditions:
- Machine settings, temperature, humidity
- Setup sequence and operator training
- Shift changes, line speed, inspection frequency
Scale and frequency:
- Very small builds can hide repeatability problems
- Staffing gaps and replenishment issues may not appear
- Operator fatigue and throughput limits often show only on longer runs

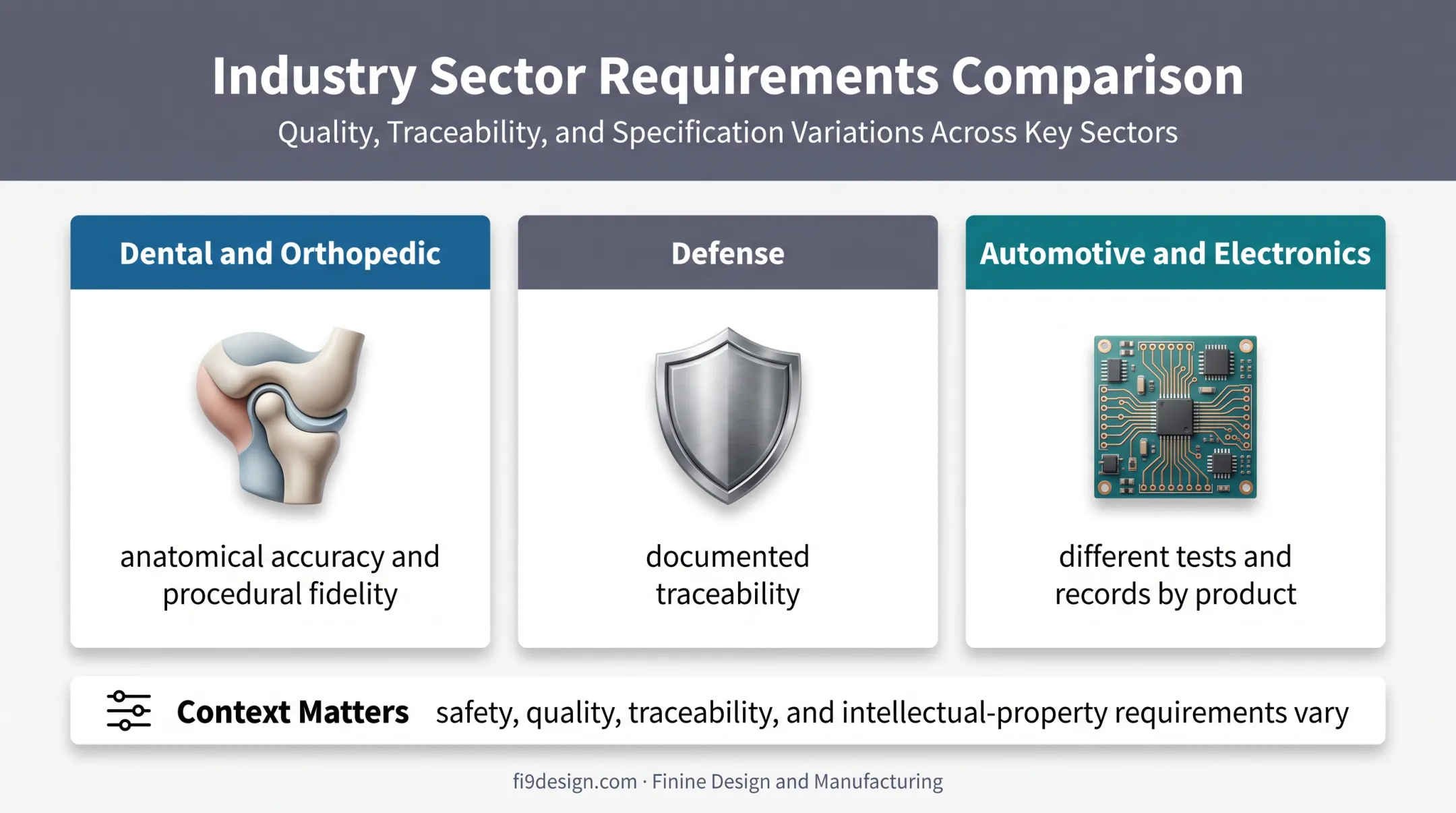

Industry context shapes the pilot, too. Automotive, defense, consumer electronics, dental, and orthopedic products each emphasize different tests and records. Dental and orthopedic programs often weigh anatomical accuracy and procedural fidelity heavily, while defense work leans on documented traceability.

Safety, quality, traceability, and intellectual-property requirements also vary by product and applicable U.S. regulations. Verify current requirements with qualified specialists rather than copying a checklist from another project.
Common Issues and When a Pilot Run May Not Be Appropriate
A few misconceptions trip up teams consistently.
"Our prototype worked, so production will too." Prototypes often use different materials, tooling, labor, or inspection methods than the production line. A successful prototype proves the design works. It does not prove the factory floor can reproduce it at scale.
"Every pilot has to happen right before mass production." Earlier pilots on a specific component, supplier, or process can leave time to fix problems before they become expensive.
Where Pilots Commonly Go Wrong
- Unclear objectives with no defined question to answer
- An arbitrary sample quantity that doesn't reflect what's being tested
- Production conditions that don't represent the intended process
- Undocumented changes made mid-build
- Incomplete inspection criteria or data capture
- Weak cross-functional communication during the build
- No defined decision point at the end
When a Pilot Isn't the Right Move Yet
A pilot run can produce misleading results when:
- The design is still changing substantially
- The production method hasn't been selected yet
- The goal is early concept exploration, not validation
- Essential production inputs aren't available yet
In those cases, feasibility reviews, CAD analysis, prototype builds, material trials, supplier samples, or engineering tests are better next steps. Use a pilot when you need early risk signals and clear evidence for a go/no-go decision. Skip it until the design and process are stable enough for those results to mean something.
Conclusion
A pilot production run bridges the gap between a promising design and a manufacturing process you can actually repeat. It tests the product, the inputs, the equipment, the people, and the documentation together, not in isolation.
The pilots that deliver real value share a few traits:
- A defined purpose tied to clear go/no-go criteria
- Production-representative materials, equipment, and conditions
- Cross-functional ownership across design, process, and quality
- Thorough records and a formal decision at the end
If you're moving from concept toward validated production, Finine Design and Manufacturing supports CAD modeling, prototyping, tooling, molding, machining, finishing, and pilot work under one roof. The team works with automotive, military, consumer electronics, dental, and orthopedic clients on this same path—from early design through a production-ready process.
Frequently Asked Questions
What does a pilot run mean in manufacturing?
A pilot run is a limited production build used to validate both the product and the manufacturing process before scaling to larger volume. It tests whether the design can be made consistently using production-intent materials, tooling, and labor.
What is another word for a pilot run in manufacturing?
Common alternatives include trial production run, pre-production run, production validation run, or production validation testing. Which term gets used depends on the industry; garment manufacturers, for instance, typically say "trial production run."
What is the pilot run process in the garment industry?
Garment pilot runs, often called trial production runs, test fabric, patterns, cutting, sewing operations, sizing, and finishing before bulk cutting begins. One documented garment-industry account describes cutting roughly 100 to 200 pieces per style as a mini-production exercise, though quantities vary by factory.
How is a pilot run different from a prototype?
A prototype primarily validates design and function: whether the product fits and works as intended. A pilot run evaluates whether the production process itself, using production-intent methods and controls, can reproduce that result consistently.
How do you know when a pilot run is ready to move to mass production?
Readiness means meeting predefined acceptance criteria, demonstrating repeatable quality and performance, resolving critical issues, and completing documentation. A formal cross-functional sign-off, not just a gut feeling that things went fine, should confirm the decision.
